Energy audits
Energy audits in Malaysia, measured on site
We log your plant with our own instruments, show you where the energy goes, and cost what is worth fixing. Where we offer it, our guarantee is simple: if the audit does not find savings worth its fee, you do not pay for the audit.

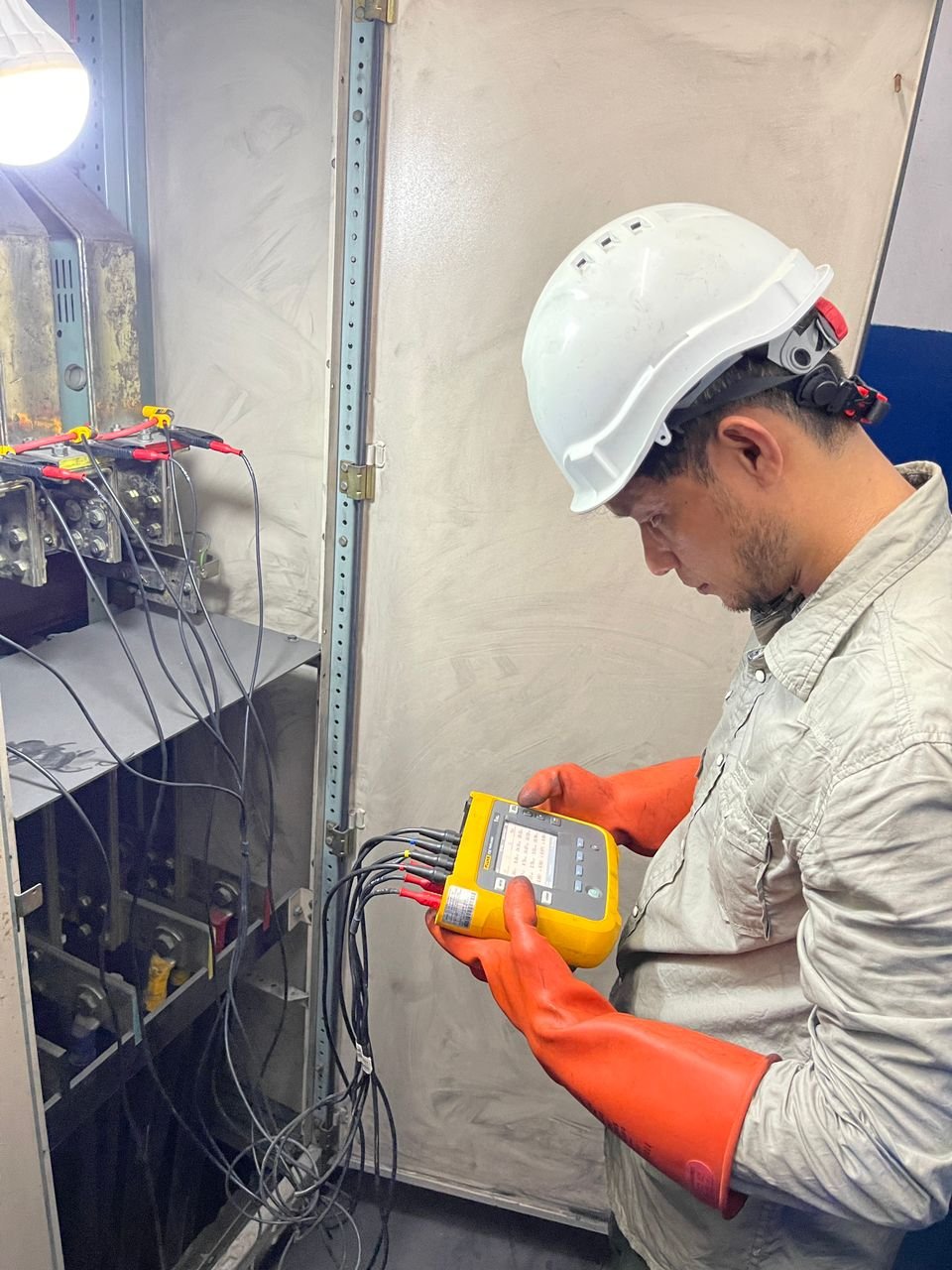

Fitting current clamps to the busbars of a low-voltage switchboard.
Registered ESCO
Work delivered under
EECA 2024 · Suruhanjaya Tenaga
Audits to
GP/ST/No.49/2024 (Pind. 1/2026) · ASHRAE Level II · ISO 50002-1
Reports signed by
Registered Energy Auditor · JTB-2025-0063/002
What we audit
Every audit is done by our own engineers, with instruments we own.
- Preliminary audit. We read your bills and walk the site. No fee.
- Plant and system audits. One system at a time: chiller plant, boiler, heat pump, compressed air or main switchboard.
- Detailed Energy Audit. The audit EECA 2024 asks for, signed by a Registered Energy Auditor. Seven to fourteen days of logging on site.
- Investment-grade audit. Thirty days of logging and a calibrated model, for a lender or a performance contract.
- Checking savings. Baselines and savings verification to IPMVP. Measurement and verification →
How a measured audit works
- Your data. Thirty-six months of bills, your tariff, operating hours and equipment list.
- Logging on site. Loggers on the big users for a full operating cycle.
- Checking. We compare the bills with what the loggers measured.
- Where the energy goes. Split across cooling, lighting, compressed air and process.
- What to fix. Each measure costed, with its saving, payback and assumptions.
- The report. Written for whoever needs it: the Energy Commission, a lender, your board or an ESCO.
If a figure is estimated rather than measured, the report says so.

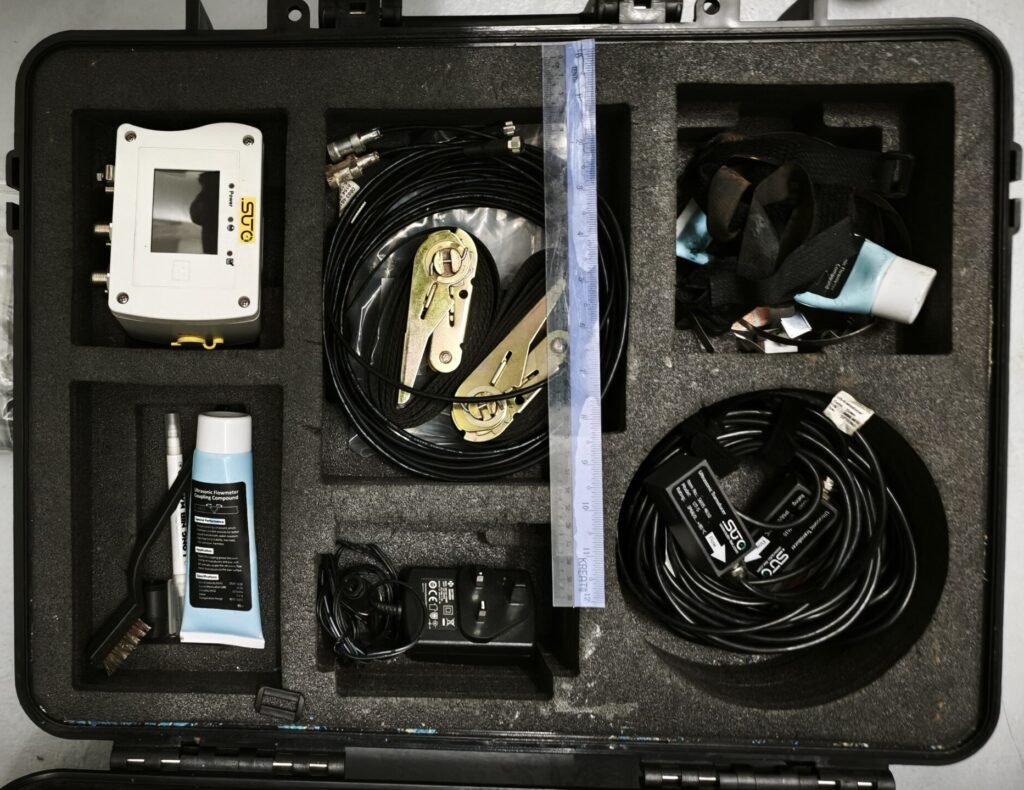

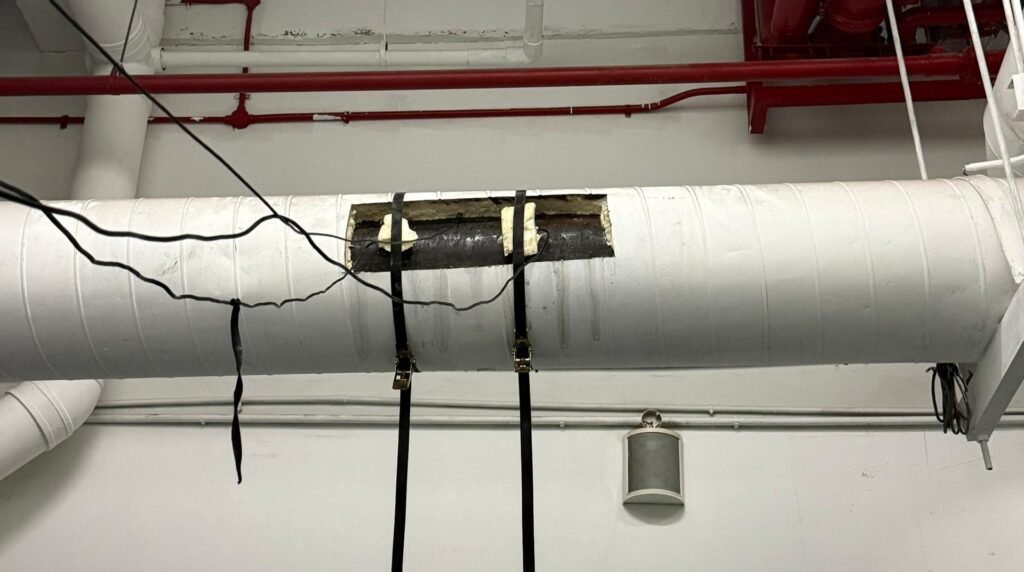

Clamp-on ultrasonic transducers on a chilled water pipe. Logged in place, no pipe penetration.
The notice we put up on site while the loggers are running.
Who signs the report
Under EECA 2024, the energy audit report is prepared by a Registered Energy Auditor (Act 861, s. 9(1)). Ours is on staff.
- Registered Energy Auditor. Signs the audit report. Practising certificate JTB-2025-0063/002.
- Registered Energy Manager, Type II. Can act as your external energy manager for up to three years after the notice.
- Certified Professional in Measurement and Verification (MGTC). Sets baselines and verifies savings.
- Certified Energy Manager (AEMAS), a Professional Engineer for metering and instrumentation, and a Green Building Index Facilitator for building fabric work.
Registrations are held by the Innovast team and its retained specialists. Names and numbers are in the engagement letter and on the signed report.
Where we have done this
Most of our work is under non-disclosure, so each job is described by type of building.
| Facility | What we did | Our role |
|---|---|---|
| Office tower, Kuala Lumpur | Detailed energy audit under SEDA EACG. Chiller plant, main switchboard and sub-circuits logged. Nine saving measures costed. | Partner ESCO |
| Pharmaceutical plant, Selangor | Detailed energy audit under SEDA EACG, and a 26-point energy monitoring system across three production buildings. | Direct |
Data halls inside office towers. Many office towers have a data hall on one floor that runs day and night. In one tower in Kuala Lumpur, the data hall used 33.5% of the building’s electricity and the chiller plant 27.9%. At night, one large chiller ran at about a tenth of its capacity, mostly for the data hall.
Figures from the audit report; the building is not named. Partner ESCO engagement. Innovast was the technical audit team.
Sectors: manufacturing and industrial, pharmaceutical, office towers, shopping malls, hotels, hospitals, government buildings, universities, water and wastewater, oil and gas terminals.
Are you an ESCO? We also work as your audit team. For ESCOs →
Our fees
Starting points for a direct engagement. We set the final scope and fee after the preliminary audit.
| Audit | What it covers | From |
|---|---|---|
| Preliminary audit | Your bills, tariff and asset list, and a site walk. You get a savings range and our advice on what to audit next. | No fee |
| Main switchboard load audit | Shows where the load sits, so you know which system to audit next. | RM5,000 |
| Heat pump system audit | Efficiency (COP) measured across the operating range. Per plant. | RM5,000 |
| Compressed air system audit | Leaks, pressure, specific power and load/unload pattern. | RM10,000 |
| Boiler plant audit | Fuel in against heat out, combustion and stack losses. | RM10,000 |

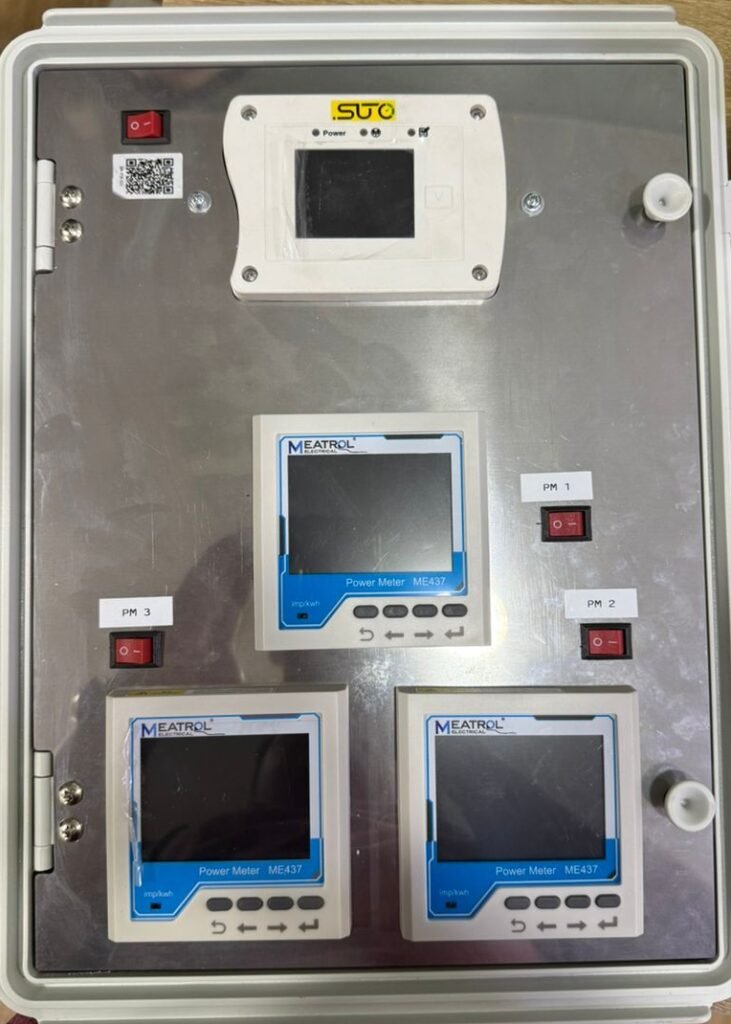

| Chiller plant audit | Power, flow and temperatures logged together, so kW/RT is measured, not calculated. | RM10,000 |
| Investment-grade audit | Thirty days of logging and a calibrated model, for a lender or ESCO. Covered by the contract if a performance contract follows. | RM40,000 |
| Detailed Energy Audit | The EECA 2024 audit, per installation. Seven to fourteen days of logging and a baseline from thirty-six months of bills. Signed by a Registered Energy Auditor. | RM50,000 commercial RM80,000 industrial |
Measurement and verification is priced on its own page. A performance contract needs no capital from you. ESCO partner rates on application.
All figures are for Peninsular Malaysia. Work in Sabah and Sarawak falls under separate registrations and is not quoted here.
Our guarantee
If the audit does not find savings worth its fee, you do not pay the audit fee. We offer this site by site, after the preliminary audit, and write it into the engagement letter.
- What we guarantee is the finding: measures identified and costed, with savings and payback. Not that you carry them out, or that the saving shows up on site. That is what measurement and verification is for.
- If your plant is new or already well run, we will tell you before you spend anything. Checking its performance may suit you better than an audit.
- What we need: site access, thirty-six months of bills, an asset list, and permission to leave loggers in place.
Illustrative only. Terms are agreed per site in the engagement letter. If we disagree on whether the savings are real, either of us can refer the findings to an Energy Performance Contracting partner within 90 days; a written offer to fund the work from those savings settles it.
EECA 2024, the label and the grant
If you have received a notice under EECA 2024, your first audit report is due within a year. From order to final report, most audits take three to five months, so start early. EECA 2024 compliance →
Office buildings of 8,000 m² or more are also rated one to five stars on their energy intensity. Energy intensity label →
SEDA’s Energy Audit Conditional Grant (EACG) can cover up to RM60,000 of a commercial audit and RM100,000 of an industrial one, for installations using 100,000 kWh a month or more. SEDA has not yet announced the next cycle. Where a grant is open, we can help you apply, subject to availability, eligibility and terms and conditions. Our audit does not depend on it.
